In an effort to fortify and enhance our service reliability while meeting the growing energy demands of the Clarke Electric Cooperative service territory, the Board of Directors has approved the construction work plan for the new year.
The work plan outlines a multi-phase initiative targeted at upgrading aging infrastructure, expanding the distribution network, and integrating newer technologies to ensure adequate and reliable electric service for our new and existing members.
"We are excited to begin our strategic construction work plan that continues our commitment to modernizing our infrastructure and providing reliable, sustainable electricity to our members," said Manager of Engineering Brad Wilson. "This initiative reflects our dedication to meeting the evolving needs of our community while embracing electric utility sector advancements."
The construction work plan, set to commence this month, includes several components:
Infrastructure Upgrades

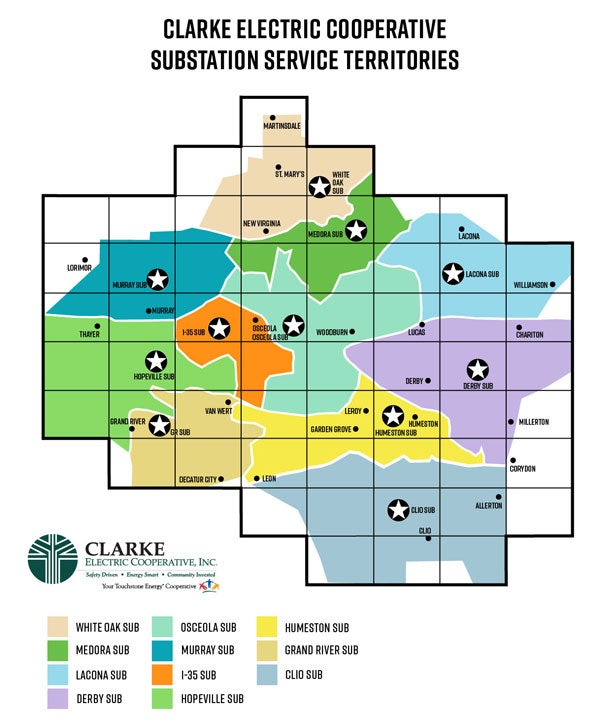

- Approximately 5 miles of overhead powerlines will be rebuilt in the Lacona area;
- 172 rejected poles serving the I-35 and Hopeville substations will be replaced;
- Aging underground cable will continue to be replaced on a performance basis;
- Three feeder exits will be replaced and reconfigured at the White Oak substation; and
- Animal guards and low side air break switches will be installed at the Medora and Murray substations.
Expansion of Service Areas
- An estimated 79 new electric services will be constructed;
- 23 service uprates are anticipated; and
- A site for a future substation in our northern territory will be explored.
Integration of Smart Grid Solutions
- The automated metering infrastructure replacement will begin, and new meter data management and analytics software will be deployed;
- Our Supervisory Control and Data Acquisition (SCADA) system will be upgraded;
- The conversion to a cellular communications backhaul for our distribution automation switches will be completed;
- Embracing innovation, the cooperative will introduce smart grid solutions aimed at optimizing energy distribution, detecting faults, and facilitating real-time monitoring to proactively address service disruptions.
Maintenance Schedule
- Right-of-way spraying will take place out of the Clio and Grand River substations;
- Hydraulic recloser maintenance will be performed out of the Derby and Humeston substations;
- General overhead and underground line maintenance will be performed out of the Hopeville and I-35 substations; and
- Two aging substation battery banks are to be replaced.
The construction work plan is designed with a focus on minimizing disruptions to consumers during the implementation phase. Residents and businesses will receive timely notifications regarding any planned maintenance or temporary service interruptions.
"We understand the importance of transparent communication and community involvement in such endeavors,” said Jason Gibbs, manager of Member Services. “We encourage our members to reach out, ask questions, and provide their valuable insights as we embark on this journey together.”
